Cable Networking Work

Laying, jointing, termination and testing of HT/LT power, control and communication cables.

All services

Delivery within the awarded scope

Planning, engineering, procurement, installation, testing and handover follow the applicable contract, approved drawings and client specifications. The systems included depend on the awarded package.

Operation and maintenance services are undertaken separately where awarded; EPC defect-liability obligations follow the project contract.

Project Experience

Anjuna underground distribution network, Goa

Goa Electricity Department awarded us the conversion of the 11 kV Anjuna feeder’s high-tension and low-tension overhead lines to underground distribution under Phase II of the National Cyclone Risk Mitigation Project.

  • We supplied and installed 319.321 km of underground cable, comprising 27.074 km of 11 kV cable and 292.247 km of low-voltage cable. These are cumulative cable-item lengths.
  • We supplied and installed 11.830 km of insulated aerial-bunched cable.
  • We completed trenching, foundations and road reinstatement and connected the underground cables using joints and terminations.
  • We supplied and installed ten 400 kVA and two 630 kVA distribution transformers, motorised 11 kV ring main units, low-voltage boards and feeder pillars. We tested and commissioned the distribution package.

Ghansoligaon underground distribution, NMMC

Navi Mumbai Municipal Corporation awarded us the conversion of Ghansoligaon’s overhead low-voltage network to underground cable distribution.

  • We laid 227.201 km of low-voltage XLPE cable across six cable sizes and connected the underground runs to feeder pillars and local connection points.
  • The 300 mm², 240 mm² and 120 mm² cable items accounted for 122.451 km. The rest comprised 35 mm² and 16 mm² items.
  • We erected eight-way, six-way and four-way feeder pillars, mini-pillars and wall boxes. The scope covered erection, earthing and jointing for 667 feeder pillars.
  • We protected the cable routes with full and half-round reinforced-concrete pipes.

Latur Integrated Power Development Scheme

Maharashtra State Electricity Distribution Company awarded us the Latur and Nilanga distribution upgrade under the Integrated Power Development Scheme.

  • We handled plant and material supply, installation services and civil works for improvements to the 11 kV, 22 kV and 33 kV network in Latur Circle.
  • We supplied and installed 47.965 km of 11 kV cable and 10.197 km of 33 kV cable underground, a combined 58.162 km of cable items.
  • In Latur, we commissioned a 33/11 kV gas-insulated substation with two 5 MVA transformers and associated switching and feeder equipment.
  • At Arvi, we upgraded the 33/11 kV substation and brought 11 kV three-core XLPE underground cable into service.

Nagpur Metro, Hingna Depot to Ambazari Lake

Nagpur Metro Rail Corporation awarded us the electrical utility shifting works for the East–West Corridor between Hingna Depot and Ambazari Lake.

  • We relocated overhead high- and low-voltage crossings and laid underground cable where existing electrical services intersected the metro works. Our scope included horizontal boring at road crossings, cable protection and end terminations.
  • We laid 12.555 km of 11 kV XLPE cable, 6.206 km of 33 kV XLPE cable and 7.800 km of LT armoured cable across three LT sizes, a combined 26.561 km of cable items.
  • We connected the new circuits to mini feeder pillars and motorised 11 kV ring main units.
  • We used reinforced-concrete and galvanised iron pipes to protect the cables where required.

22 kV and 33 kV cable conversion, Nerul

CIDCO awarded us the conversion of 33 kV overhead lines and relocation of existing 22 kV and 33 kV underground cables crossing development plots in Sector 19, Nerul.

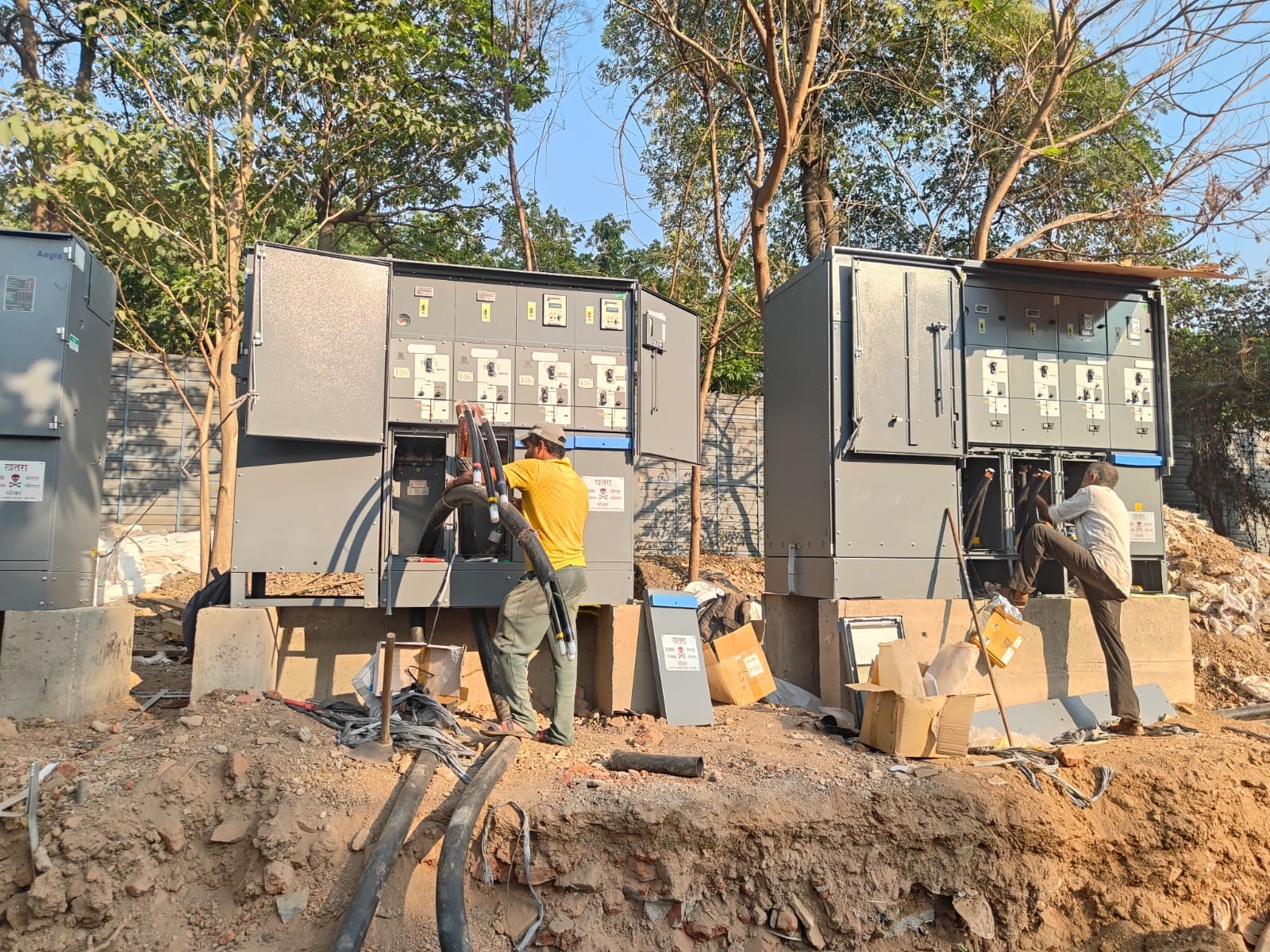

RMU cable termination works
  • We laid 13.5 km of 22 kV cable and 10.8 km of 33 kV cable, both three-core, 300 mm².
  • We connected eight 22 kV and five 33 kV four-way ring main units, each rated 630 A. Our 33 kV switching scope included motorised units with vacuum circuit breakers and compatibility with supervisory control.
  • We completed 2.6 km of horizontal directional drilling with a bore diameter of 200 mm.
  • We completed the physical works and commissioned the underground network.
View project photos and details

Nagpur Metro, RR Substation to Khapri

Nagpur Metro Rail Corporation awarded us the relocation of electrical utilities between the RR Substation and Khapri station on the North–South Corridor.

  • We shifted overhead HT and LT infrastructure and laid underground cable. Our scope covered joints, end terminations and protective pipes where required.
  • We laid 19.890 km of 11 kV XLPE cable and 4.353 km of LT armoured cable, a combined 24.243 km of cable items.
  • We connected mini feeder pillars, an oil-immersed 11/0.415 kV distribution transformer and motorised 11 kV ring main units with load-break switching and circuit-breaker configurations.
  • We erected overhead support structures and provided surge protection where the relocated infrastructure connected with the new circuits.

33 kV trenchless cable installation, Tivim to Colvale Bridge

Goa Electricity Department awarded us the tender for the 33 kV cable link from Tivim Substation to Colvale Bridge as part of the supply connection to the Tuem Electronic City substation.

  • We laid three-core, 400 mm², 33 kV cable as part of the connection serving the two 20 MVA transformers at Tuem.
  • We used horizontal directional drilling for the trenchless installation, with screened, XLPE-insulated armoured cable, protective HDPE ducts and cable jointing within the scope.
  • The package also provided for conventional trenching in hard laterite where required. We completed the cable works between Tivim and Colvale Bridge.
View project details

Yewai to Panjrapur power and optical fibre network

Brihanmumbai Municipal Corporation awarded us the HT, LT and optical fibre cable package for the Yewai Pre-Chlorination Plant, Master Balancing Reservoir and Panjrapur Water Supply Complex.

  • We supplied and installed HT power cables from Panjrapur to the chlorination plant. Our scope called for three-core, 400 mm², 3.3 kV cable with terminations at both ends.
  • We supplied and installed LT power cables to the reservoir control room. Our scope called for 150 mm², 1.1 kV-grade power cables with joint-free runs across the specified section.
  • We provided the six-core, single-mode armoured fibre link for communications. The highway crossing scope called for horizontal directional drilling and protective HDPE ducts.
  • We completed the HT, LT and fibre package. The power works called for pre-commissioning site tests and for the existing installation to remain in operation until the new circuits were ready.
